About the Project
The Council's Urban Roads and Drainage Improvement Program has helped improve infrastructure in Bass Coast for many years.
These upgrades are usually delivered through Special Charge Schemes. This is a way for Council to raise money for an upgrade project by charging property owners that benefit from the upgrade. This is allowed by the Local Government Act 1989.
This process means many communities now have better infrastructure like sealed roads, kerbs, footpaths, drainage, and other important facilities. The Council also helps pay for these projects if they benefit the wider community, not just the upgraded area.
The project to upgrade Links Street was started in response to a petition to Council that was received in February 2024.
The project was supported by property owners through the legislative process and formally declared in October 2025. Updates on the project will be provided below.
What will it look like?
Project Update May 2026
Council is continuing to progress the road and drainage upgrade for Links Street.
A timeline is provided below to keep property owners and stakeholders informed of the current progress.
At this stage, construction works are anticipated to commence in mid‑late 2027.
Next steps
June 2026
Detailed design completed
Detailed design is currently being finalised by Beveridge Williams.
September 2026
Invoices sent to property owners
As per the Local Government Act 1989, invoices must be issued to property owners within 12 months of the declaration of a Special Charge.
November 2026
Cultural Heritage Management Plan complete
A Cultural Heritage Management Plan (CHMP) is a document that outlines how Aboriginal cultural heritage is protected and managed during construction and associated works. A CHMP is required when works are proposed in an area of cultural heritage sensitivity.
The CHMP process has already been commenced and is being completed in consultation with the Bunurong Land Council Aboriginal Corporation and a Heritage Advisor.
Late 2026/early 2027
Permits application
Once the Cultural Heritage Management Plan has been received, Council will apply for the necessary permits to undertake vegetation removal, complete Coastal Acid Sulphate testing and receive MACA (marine and coastal area) consent.
Early-mid 2027
Contract Tendering and Award
Mid-late 2027
Onground construction
Project Update February 2026
Council officers have been working with Beveridge Williams to undertake detailed design. This involves refining the details outlined in the Concept Plan to ensure all elements meet the aims of the project and are functional when construction occurs.

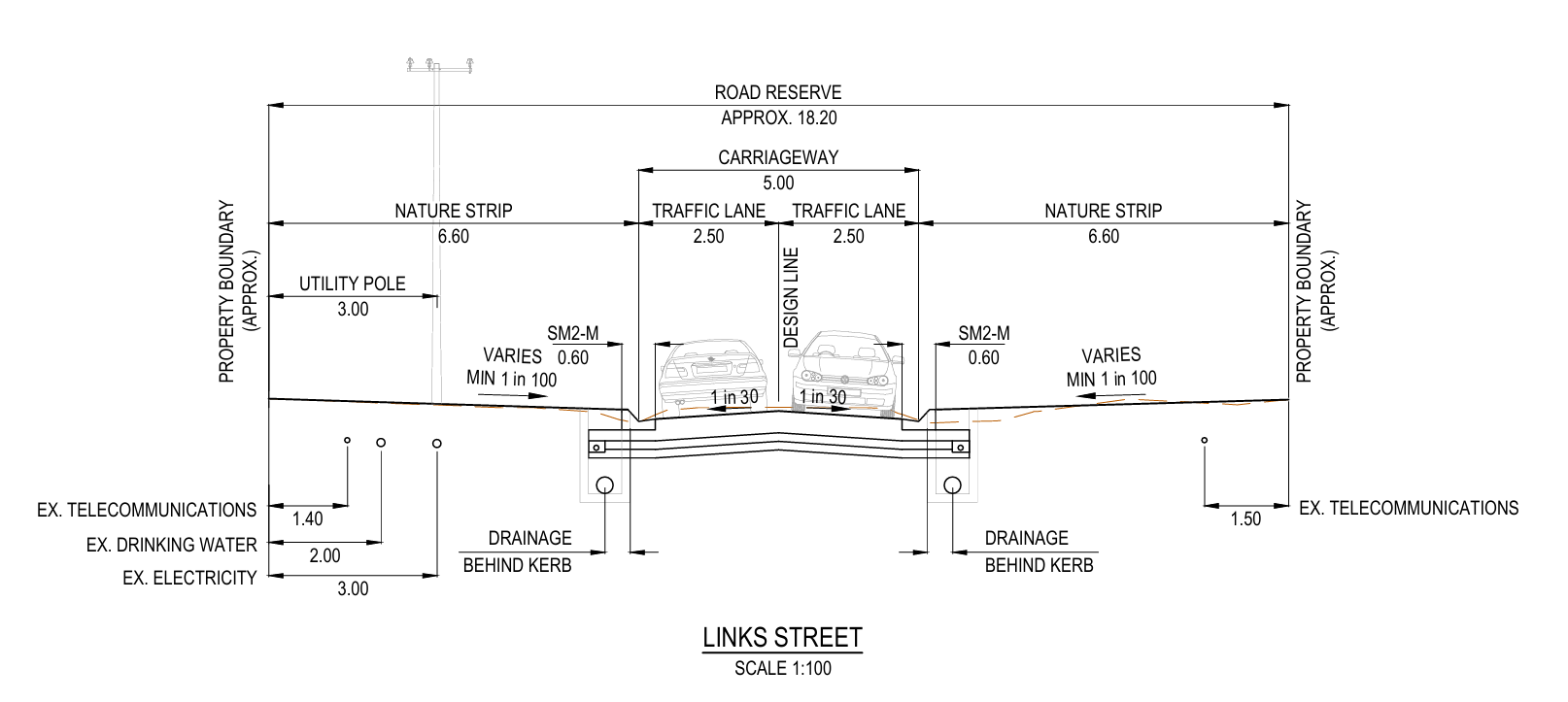

The functional layout plans for the project can be viewed here. A cross section of the road design is shown below.
On ground service proving (locating underground utilities) has also commenced.
There is a variety of investigations that must be completed prior to construction including:
- Targeted species flora and fauna surveys
- Cultural Heritage Management Plan
- Coastal acid sulphate soil testing
These processes have been initiated by Council.
Next steps
- Detailed design is schedule to be completed by June 2026.
- Council will seek requests for tender through Council's procurement Policy to ensure value for money for property owners and Council.
- Permits for vegetation removal will be completed after detailed design.
Outcome of legislative process
